Sylvania Strong

Phase 1 - downtown improvement project (complete)

We are pleased to announce that Phase 1 of the Downtown Improvement Project is nearing completion. While some final touches—such as sidewalk refinements and seasonal landscaping—await the warmer spring weather, this milestone represents a major leap forward in modernizing our Downtown corridor. Beyond essential utility upgrades, the new footprint creates a more inviting atmosphere with enhanced lighting, convenient parking, and accessible pathways framed by comfortable seating and vibrant greenery.

Check out the Construction Time-lapse Camera below!

phase 1.5 - utility bury (Active)

We have now transitioned into Phase 1.5. Before the official Phase 2 construction can begin, utility lines along Main St between Maplewood Ave and Erie St will need to be relocated from overhead to underground. The work of installing that infrastructure is scheduled to begin in January 2026. By moving these power and communication lines beneath the surface, we are not only enhancing the visual appeal of our historic district but also increasing the long-term reliability of our utility services. In coordination with the project, Summit St between Monroe St and Erie St will receive new poles to accommodate Toledo Edison’s electric service improvements. Work is expected to be completed before the start of Phase 2 in July 2026.

phase 2 - Downtown improvement Project (Tentative July 2026)

Phase 2 of the Downtown Improvement Project is set to begin as early as July 2026. Phase 2 will extend the signature look and feel of Main Street’s first block through to the second, covering the area between Maplewood Ave and Erie St. Our goal is to complete the primary infrastructure—including roadways, sidewalks, and park enhancements—before winter, with final aesthetic touches wrapping up in Spring 2027.

Check out the 3D rendering video from the Public Open House below!

PHASE 1.5 – UTILITY BURY

Construction to install the infrastructure necessary to relocate all the overhead utilities to underground on Main St from Maplewood to Erie St will begin in late January 2026.

PHASE 2 – DOWNTOWN IMPROVEMENT PROJECT

Construction for Phase 2 is tentatively scheduled for July 2026. The City of Sylvania held a Public Open House on January 13, 2026 to showcase multiple exhibits and take public feedback for the Phase 2 project. Check out the “Looking Towards the Future” tab to see the renderings. Visit the City of Sylvania Website to see the 3D version of the renderings.

https://www.cityofsylvania.com/government/engineering/downtown-transportation-improvements-vision-planning-project/

Erie to maplewood

Phase 1.5 milestones

Stage 1

Dates: January 19th – mid-February 2026

Working Being Done:

Directional bore underground conduit under Monroe St at Summit St

Removal of trees along Main St from Maplewood Ave to Erie St

Traffic Adjustments: No traffic impacts

Stage 2

Dates: Mid-February 2026 – April 2026

Working Being Done:

Removal of portions of sidewalk and curb lawn on the east side of Main St from Maplewood Ave to Erie St

Minor sidewalk removal on the west side of Main St.

Installation of underground conduit and utility boxes on east and west side.

Traffic Adjustments: Main St northbound traffic from Maplewood Ave to Erie St shifted over to southbound lane. No southbound traffic.

Stage 3

Dates: April 2026 – July 2026

Working Being Done:

Electric and Communication companies install new cables and services.

Toledo Edison to install new power poles on Summit St.

Traffic Adjustments: Re-open southbound traffic.

Boutique & Retail

Ace hardware

Angela's Angels

Blue Layne Boutique

Beautiful Blooms by Jen

Black rose Cigars

Chris and Kristy's Boutique

Fiddle stix boutique

Finch & Fern

Fuller Art House

Harmony in life

Hip to the Groove

Hudson Gallery

Kroger

Main Street Sweets

Ragazza

Sautters

Simply Stacked

Speedway

Spoke Life Cycles

Sylvan Studio

The art Supply Depo

V Collections

Village Candy Shop

Restaurants

Bandits Main Street Eats

Chandler Cafe

Ciao!

Erin Ann's

Frickers

Inside the five

J&G's pizza palace / dallas taproom

Jimmy Johns

Little Caesars Pizza

Local Roots

Olive's on Main

Sodbuster

Personal Services & Care

Clean Express Car Wash

Hair!

Keith's Hair Design

Reve Salon & Spa

Sandlot Barbershop

Shear Madness salon

Sheer Perfections

Solis Studio

Solstice A Salon

Willow Creek Salon

Health & Wellness

Affordable Dentures & Implants

California Yoga

Finding You Psychotherapy & Yoga

Healthy Family Chiropractic

HLH Orthodontics

Manahan

Toledo Mindfullness Institute

Vibrant Chiropractic

Vision Center

Vista Living Care

Business & Professional Services

Attorney - Kenneth W. Wenniger

Bel Main

Bull moose Retirement

Celebration Title

Edward Jones

HealthMarkets Insurance - Shelby Parton

Huntington Bank

JDRM Engineering Inc.

Jem Photography

Keybank

Mark Feldstein & Associates

McGuire Insurance

Reeb Funeral Home

Root Building

SOMO

Space Bar

State bank & trust

State Farm

Stough & Stough

Sylvania Advantage

Sylvania Area federal Credit union

Toledo Ballroom

Toledo Memorial Park

Udell Law

Unverferth Interiors Inc

W Drescher & Associates

Webb Builders

Wilson Printing

Wingate

Art & Education

Chords with Cory

Create: Art Studio & Workshop

Heritage Sylvania

Sylvania Kindercare

Sylvania Chamber Members

Sylvania Strong is a community-driven effort to support local businesses and residents during the upcoming construction projects. Our goal is to keep our city thriving by providing resources and updates to the community and businesses.

Yes! Fall Festival will still occur and will be October 17th & 18th. More information to come.

Follow our community newsletter! Sign up with your email using the pop up below! You can also email nmcdonald@sylvaniachamber.org to be put on the email list if the pop up is not available.

No. There will be no change to the structure of the buildings.

Yes. All the events for Red Bird including First Friday will proceed to occur downtown as planned. More information for these events can be found at https://redbirdsylvania.org/

Yes. The parade will still take place. More information to come.

No. There will not be a roundabout on Erie and Main.

As of now, crews do not plan on working on weekends or plan to work after dark.

There will be lane closures, but Main St will remain open to traffic for the duration of the project

The Blade Article

Sylvania to start Phase 2 of Main Street improvements uptown

01/14/26

WTOL News Feed

Sylvania open to public feedback o downtown construction

01/13/26

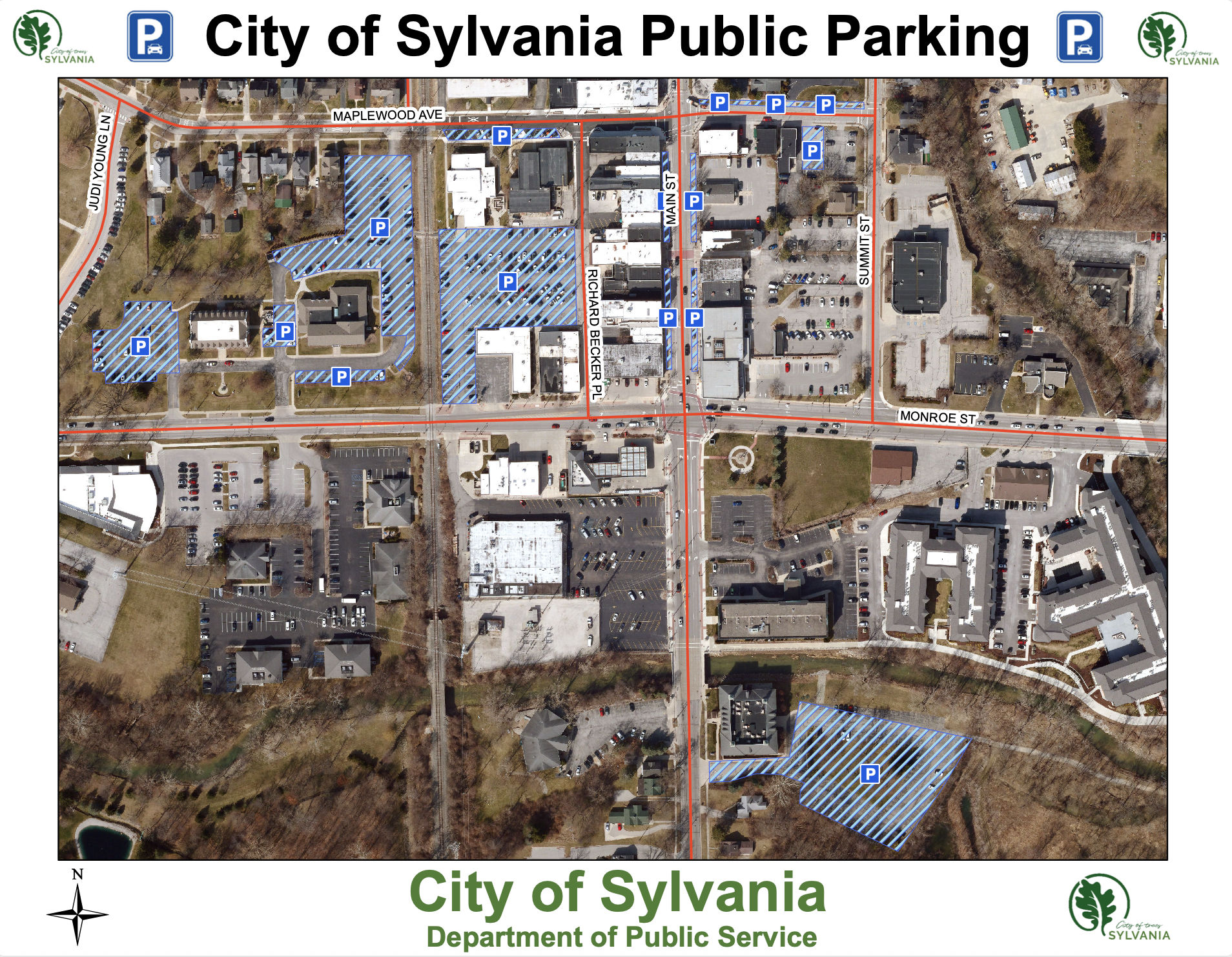

City of Sylvania Parking Map
